Oil Sludge Harmless Treatment Project in Africa: Green Transition from Incineration to Pyrolysis

BLJ-16 Oil Sludge TDU Project Commissioning in Nigeria
Beston engineer and local staff took a group photo after the successful commissioning of the BLJ-16 TDU in Africa. (Credit: December 2025)

1. Project Background

Customer Industry

The customer is a medium-sized solid waste recycling and management company in West Africa.


Challenges

Before introducing the new solution, the customer mainly adopted the traditional incineration method, facing difficulties:

  • Severe environmental pollution: Black smoke and harmful gas emissions from incineration lead to environmental regulatory pressure.
  • Harsh operating environment: High temperature, dust and odor pose high health risks to operators.

Core Goals

The customer clearly put forward the transformation demand, seeking a TDU system that ensures environmental compliance and stable operation.

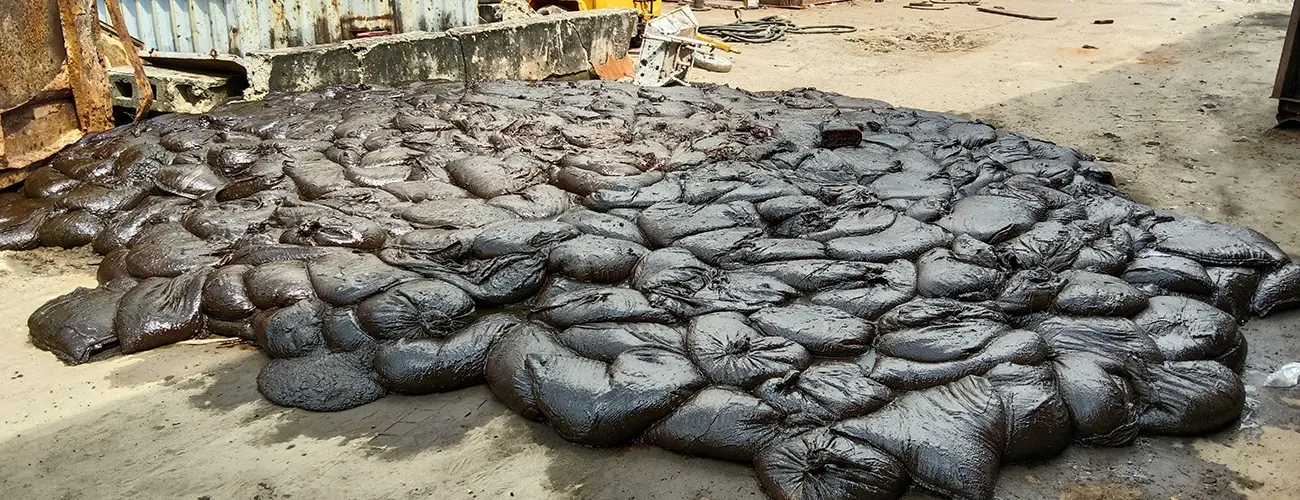

Local Drill Cuttings
Local Drill Cuttings

2. Solution and Project Details

Model Configuration

  • Model: BLJ-16 thermal desorption unit (standard configuration)
  • Process Capacity: 16-18t/batch
  • Working Method: Batch
  • Feeding System: Screw feeding with belt conveying

Project Information

  • Raw Material: Oil-based drill cuttings (moisture & oil content: ~35%)
  • Product Application: Pyrolysis oil for self-consumption as fuel
  • Installation Period: 43 days
  • Installation Support: On-site guidance by Beston engineer

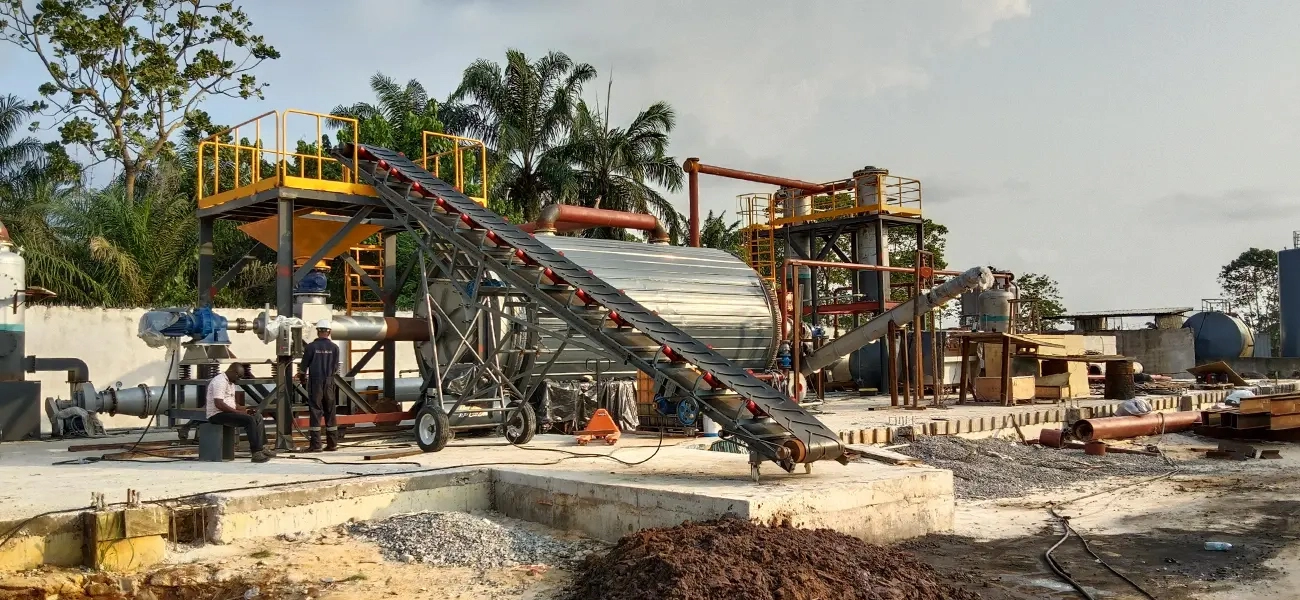

16-18 TPD Oil Sludge Thermal Desorption Unit Installation Site
Installation of the BLJ-16 Thermal Desorption Unit in Africa, designed to treat 6,500 tons of oil sludge annually. (Credit: December 2025)

3. 43 Days On-site Guidance: Installation/Comissioning/Training

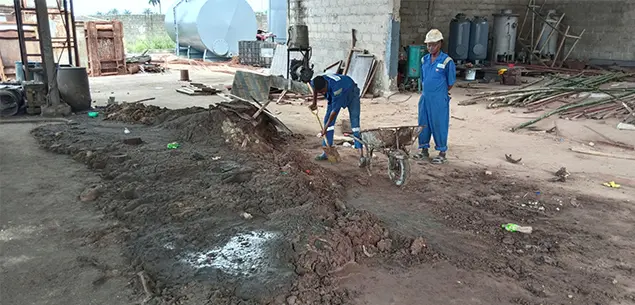

Site Clearing

Week 1: Construction Coordination

  • Site & Personnel: Finalized foundation setting-out and equipment positioning; clarified the installation plan and optimized manpower to ensure the project remains on schedule.
  • Pre-assembly: Synchronized the ground welding and assembly of key components (condensers, etc.) to improve subsequent installation efficiency.

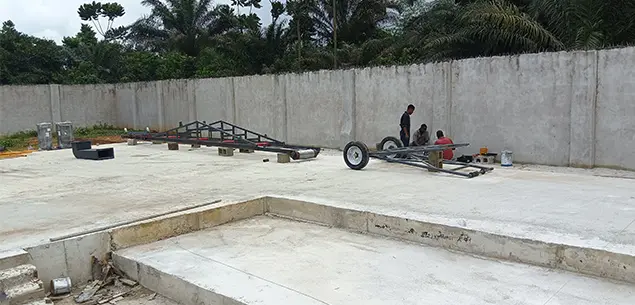

Belt Conveyor Pre-assembly

Week 2: Module Assembly

  • Component Assembly: Continue assembly and welding of multiple parts, including belt conveyors, slag screws, flue condensers, etc.
  • Goods Inspection & Procurement: Identified damaged or missing parts early and coordinated local procurement with the client to avoid schedule delays caused by cross-border replenishment.

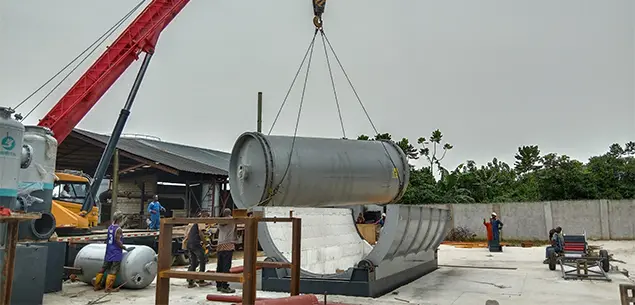

Pyrolysis Reactor Hoisting

Week 3: High-precision Hoisting

  • Core Equipment Hoisting: Completed hoisting of pyrolysis reactor, casing, feeding platform, oil storage tank, etc.
  • Pre-assembly: Continue assembly and welding of components including belt conveyors, spray towers and water pump supports.

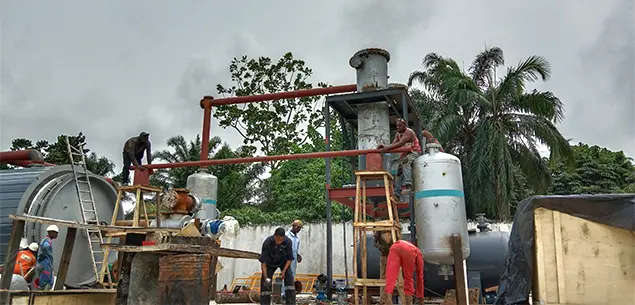

Pipeline Installation

Week 4: Pipeline Construction

  • Pipeline Construction: Completed construction of oil-gas pipelines, flue gas pipelines, fuel gas pipelines and oxygen supply fan pipelines.
  • Site Coordination: Supervised the client and construction team to rectify delayed works; repaired deformation at the bottom of the oil-gas condenser caused by unloading.

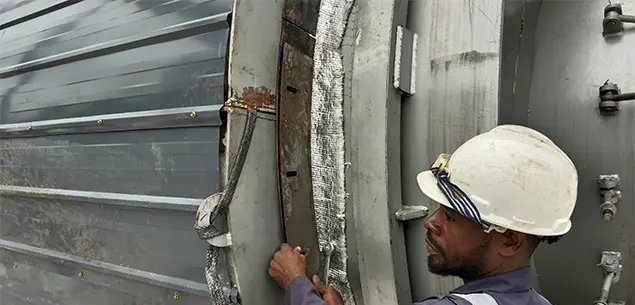

Reactor Door Installation

Week 5: Installation & Welding Works

  • Component Installation: Completed installation of burners, air compressors, instruments, tank connections, furnace doors, slag discharge parts, etc.
  • Auxiliary Welding: Carried out tack welding and full welding of spray towers, pipelines, ladders, reducers, etc.
  • Electrical Preparation: Cables arrived on site; completed fabrication of electric control cabinet supports and coordinated electricians for on-site construction.
